McKinney ISD VATRE Faces Critical Nov. 3 Vote With $500M Bond

MCKINNEY, Texas – McKinney ISD voters will decide five separate propositions on Nov. 3, 2026: a McKinney ISD VATRE that district officials say would net about $4.1 million a year after state recapture, plus a $500 million bond package split across Propositions B through E for schools, safety, technology, a training-pool repair, and stadium turf and track work.

Trustees unanimously called the bond and Voter-Approval Tax Rate Election at their Aug. 10, 2026, meeting, according to the district’s official release and contemporaneous Community Impact reporting. Early voting runs Oct. 19–30. The last day to register or update a registration for this election is Monday, Oct. 5, 2026, thirty days before Election Day under Texas rules. Polls on Nov. 3 are open 7 a.m. to 7 p.m.

This report focuses on what is on the ballot, how the bond dollars are split, what the McKinney ISD VATRE keeps after recapture, and the registration clock. Never Late News separately covered the district’s adopted $1.0664 total tax rate; that rate story is background here, not the lede.

What Proposition A, the McKinney ISD VATRE, actually funds

Proposition A is not a construction bond. Bond dollars pay for buildings, buses, and equipment. They cannot fund teacher salaries. The McKinney ISD VATRE asks voters to ratify a maintenance and operations enrichment layer so day-to-day classroom costs stay in the operating budget.

District election materials describe the VATRE as $0.0317 added to the state’s compressed 2026–27 M&O rate of $0.7147, producing an adopted M&O rate of $0.7464 when combined with an Interest and Sinking rate of $0.3200 for a total of $1.0664 per $100 of taxable value. That total is 3.79 cents lower than the prior year’s $1.1043, and the district says all five propositions can be financed within that lower posted rate if voters approve them.

CFO Marlene Harbeson told trustees the McKinney ISD VATRE could generate roughly $9.1 million in gross M&O revenue, Community Impact reported from the Aug. 10 presentation, but higher collections also raise recapture payments. “The net effect of that is around $4.1 million,” Harbeson said in that coverage. The district’s own board announcement matches the net figure: about $4.1 million annually after recapture for teacher compensation, classroom programs, student support, transportation, and campus staffing.

Without the net revenue from the McKinney ISD VATRE, officials say the district would have to consider further cuts that could hit Fine Arts, Athletics, Gifted and Talented, and Career and Technical Education. Prop A materials stress the same point in plain language: bond money builds and repairs; Prop A pays people and programs.

How a $23 million shortfall became a roughly $6 million gap

The McKinney ISD VATRE was not the district’s first move. Facing a roughly $23 million deficit in 2024–25, the district cut staffing and departmental budgets, imposed hiring controls, reviewed programs, and chased operating efficiencies. Superintendent Shawn Pratt’s election-site letter says the district reduced staff and budget by about $15 million two years ago and later saved at least $3 million a year by repurposing three under-used campuses.

After those steps, district materials say the remaining shortfall is about $6 million. The 2026–27 budget was adopted with a projected $6 million gap, Community Impact noted, marking a third straight year of shortfall budgeting after roughly $21 million in 2024–25 and nearly $7 million in 2025–26 under that reporting’s framing. Prop A is framed as closing the remaining operating gap so the next round of reductions does not come out of classrooms.

A January 2026 Mesirow Public Finance evaluation cited in the district release ranks McKinney ISD first among the 100 largest Texas districts for college readiness and second for College, Career, and Military Readiness, while spending about 2 percent of its budget on administration, roughly half the statewide average. Those figures are district-cited performance context, not a guarantee of future results.

Propositions B–E: the $500 million bond split

Propositions B through E together total $500 million and appear on the ballot separately from the McKinney ISD VATRE. Texas law requires school-bond ballot language to carry the statement “THIS IS A PROPERTY TAX INCREASE,” even when a district argues its posted total rate is falling. McKinney ISD’s voting-information page makes that statutory point explicit and repeats that if all five propositions pass, the total rate would still be lower than last year. Appraisal values set by Collin Central Appraisal District can still move an individual bill up or down.

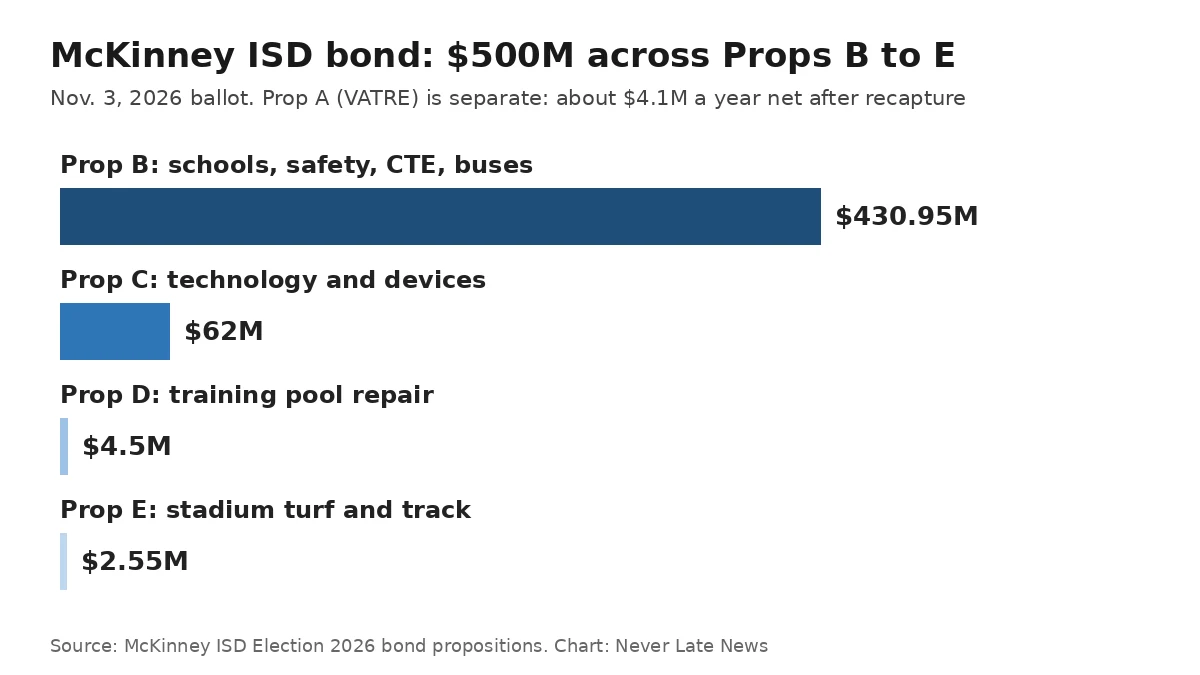

McKinney ISD VATRE ballot chart showing the $500M bond split across Propositions B through E
Proposition B carries about 86 percent of the $500 million bond. The McKinney ISD VATRE, Proposition A, is a separate operating-revenue question. Source: McKinney ISD Election 2026 bond propositions.

Proposition B: $430.95 million

Proposition B is the large facilities package: school renovations, safety and security upgrades, two new elementary schools in growth areas, Career and Technical Education facilities, and new buses. Major work listed by the district includes aging roofs, HVAC, plumbing and electrical systems; surveillance, alert, and emergency communications upgrades; and a shared CTE facility with Collin College.

Enrollment pressure is uneven. The Educational Facilities Alignment Committee found residential growth in the northwest and northeast crowding Frazier, Press, and Webb Elementary, while southwest and southeast elementary enrollment has declined. Scott Johnson Middle School and McKinney North High School face enrollment pressure; other secondary campuses are declining, according to the district’s Election 2026 overview. The two new elementaries are aimed at the growth corridor those committees identified.

Proposition C: $62 million

Proposition C funds instructional technology and network equipment, including student devices replaced on a planned cycle rather than in emergency batches, per bond-proposition materials.

Proposition D: $4.5 million

Proposition D covers repairs to the existing training pool, originally built in 1986. Community Impact identified the McKinney High School training pool. District materials describe Prop D as extending the life of an asset the community already owns rather than building a new facility, and note it is less than 1 percent of the total package.

Proposition E: $2.55 million

Proposition E replaces turf and track at existing district stadiums. District pages say the turf at McKinney ISD Stadium is aging and the track at Ron Poe Stadium needs foundation work and resurfacing. At $2.55 million, it is the smallest proposition, about half of one percent of the package. (Some secondary coverage rounded the figure to $2.5 million; the district’s official bond split uses $2.55 million.)

Collin College CTE partnership and the $28 million M&O claim

A central selling point inside Proposition B is a shared career and technical education center with Collin College. District officials say Collin College was also considering a CTE center in the McKinney area. Rather than build two overlapping facilities, the partners propose one shared site so every McKinney ISD high school student can access programs that would be too expensive to duplicate at each campus.

The district’s Aug. 11 board announcement states the partnership “ultimately saves taxpayers approximately 350 million dollars over the 50 year agreement period.” That is a district savings claim over the life of the agreement, not an audit figure independently verified for this article.

The same release estimates that dedicating bond dollars to major repairs, buses, and equipment that would otherwise hit the operating budget “could preserve more than $28 million annually for teacher salaries, classroom programs and daily operations over the life of the bond program.” Again, that is an official estimate of M&O capacity preserved by shifting capital costs to I&S-backed bonds, not new cash dropped into classrooms each year without voter approval of the bonds.

Board President Amy Dankel said in the release that the proposal reflects months of study by two board-appointed citizens’ committees and that the district is committed to giving voters clear facts on all five propositions. Pratt’s message on the Election 2026 site frames the package as coming after cuts and campus repurposing, not before them.

Tax-rate math voters will still see on the statement

Never Late News previously reported McKinney ISD’s adopted $1.0664 total rate, 3.79 cents below the prior $1.1043. Election financial pages break the same math into compression (M&O from $0.7343 to $0.7147), an I&S cut from $0.3700 to $0.3200, and the $0.0317 McKinney ISD VATRE enrichment on top of the compressed M&O rate.

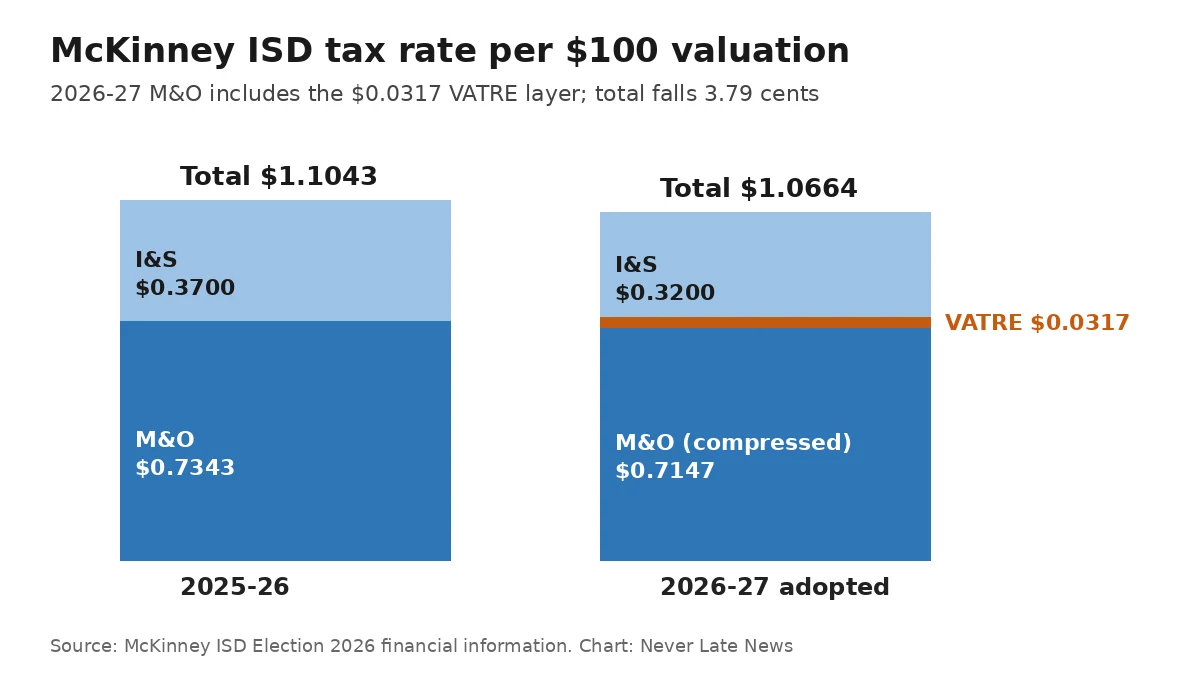

McKinney ISD VATRE tax rate chart comparing 2025-26 and 2026-27 M&O and I&S rates
The McKinney ISD VATRE adds $0.0317 to the compressed M&O rate, while a 5-cent I&S cut brings the total to $1.0664, down from $1.1043. Source: McKinney ISD Election 2026 financial information.

For a median-valued homestead, district financial tables show taxable value moving from $382,757 to $368,036 and an estimated school tax bill moving from $4,227 to $3,925, about $302 lower, if the $1.0664 total applies. Individual bills still depend on appraisal values, exemptions, and ceilings. Trustee Kenneth Ussery noted at the Aug. 10 meeting that ballot wording will say voters are increasing the tax rate even as the district argues the posted total is nearly four pennies lower, Community Impact reported.

Related Never Late News coverage in the North Texas education and civic finance cluster includes McKinney ISD’s $1.0664 tax-rate adoption, Keller ISD’s flat $1.0852 tax-rate hold, and the Dallas ISD Bond 2026 design charrette.

What to verify before the Oct. 5 registration deadline

Homesteaders and staff watching the McKinney ISD VATRE and bond package should check primary documents, not social summaries:

  1. Proposition dollar splits: B $430.95M, C $62M, D $4.5M, E $2.55M, plus Prop A’s ~$4.1M after-recapture claim.
  2. That each proposition stands alone; approving one does not pass the others.
  3. Registration or address updates by Monday, Oct. 5, via Collin County Elections or VoteTexas.gov, with mailed applications postmarked by the deadline.
  4. Early voting Oct. 19–30 at any Collin County early-voting location, and Election Day hours 7 a.m.–7 p.m. on Nov. 3.
  5. Sample ballot and polling place through Collin County Elections once final lists post.
  6. Mail-ballot applications, for voters who qualify, must be received by Oct. 23 per district voting-information materials.

District project detail, FAQs, and financial tables live on McKinney ISD’s Election 2026 hub, including bond-proposition and Prop A explainers.

McKinney ISD VATRE and bond: quick answers

What is Proposition A?

Proposition A is the McKinney ISD VATRE, a voter-approval tax rate election that ratifies a $0.0317 maintenance and operations layer. District officials estimate it would raise about $9.1 million gross and about $4.1 million a year after state recapture, money meant for salaries and programs rather than buildings.

Does the bond raise my tax rate?

Ballot language must say “THIS IS A PROPERTY TAX INCREASE.” The district says that if all five propositions pass, the total rate would still be $1.0664, lower than last year’s $1.1043. Individual bills depend on appraised value, exemptions, and ceilings.

Can voters approve some propositions and reject others?

Yes. Each of the five propositions is a separate ballot item, so the McKinney ISD VATRE can pass or fail independently of the $500 million bond, and each bond proposition stands on its own.

What are the key dates?

The registration deadline is Monday, Oct. 5. Early voting runs Oct. 19–30, mail-ballot applications must be received by Oct. 23, and Election Day polls are open 7 a.m. to 7 p.m. on Nov. 3.

How Never Late News reported this

Never Late News based this report on McKinney ISD’s official Aug. 11, 2026, article calling the bond and VATRE election, including the five-proposition structure, Proposition B–E dollar amounts ($430.95M, $62M, $4.5M, $2.55M), the ~$4.1 million after-recapture McKinney ISD VATRE figure, the $23 million-to-~$6 million deficit reduction narrative, the Collin College ~$350 million over 50 years savings claim, and the ~$28 million annual M&O preservation estimate.

We cross-checked proposition scopes, growth-corridor campus names, pool and stadium detail, voting dates, and tax-rate component math against the district’s Election 2026 hub pages for the board announcement, bond propositions, Prop A, financial information, and voting information.

Unanimous Aug. 10 board action, the ~$9.1 million gross / ~$4.1 million net VATRE framing, median-homestead bill estimates, and Ussery’s and Harbeson’s quoted remarks were cross-checked with Community Impact’s Aug. 10–11, 2026, coverage. Registration deadline framing was checked against district voting materials and the Texas Secretary of State’s Oct. 5, 2026, statewide reminder.

Primary district release: McKinney ISD Board Calls Bond and VATRE Election. We did not invent interviews or independently audit Collin Central Appraisal District rolls or the 50-year CTE savings model for this draft.

Corrections and reader feedback

If you spot an error in proposition amounts, VATRE revenue figures, tax-rate components, campus names, or election dates, email editor@neverlatenews.com with the correction and a source link. Never Late News corrects factual mistakes promptly and notes substantive updates when McKinney ISD or Collin County revises election materials.

About Never Late News: Never Late News is a US local and civic news site covering budgets, taxes, schools, housing, and public services with people-first reporting. This article carries the byline Douglas S. Doyle.
